Emergency power outages canceled: strict hourly schedules introduced

Читати українськоюЧитать на русском
Emergency power outages canceled: strict hourly schedules introduced
Emergency power outages canceled: strict hourly schedules introduced

On November 28, electricity shutdowns were canceled in Ukraine, which were implemented due to a massive attack by the Russian Federation on energy facilities.

All regions returned to scheduled power outages but the regime became more stringent – three consumer groups are now shut off simultaneously. Thus, for example, in Kyiv, consumers will be without power for 7 hours in a row, twice a day.

This was reported by "Ukrenergo". "All consumers are returning to scheduled power outages," the report says.

Shortly after, energy workers clarified that three shifts of residential consumers will be cut off simultaneously until the end of the day. "The reason for the temporary tightening of restrictions is damage to energy facilities during the massive missile and drone attack on November 28. The energy workers are working to restore the equipment damaged by the enemy as soon as possible," the company explained.

Emergency shutdowns were canceled on November 28 dqxikeidqxidqeant

It is not ruled out that the time and volume of restrictions may still change. "You can find out the latest information about the shutdown schedules in your region on the website or the official pages of the regional energy companies in social networks," they added in "Ukrenergo."

The company reminded that they only determine the number of shifts that need to be disconnected. The actual shutdown schedules for each individual shift are already being prepared by the regional energy companies.

In particular, energy company DTEK published updated schedules for Kyiv and the Kyiv region. The maximum time without electricity has increased to 7 hours in a row, meaning so-called gray areas of disconnection have been involved.

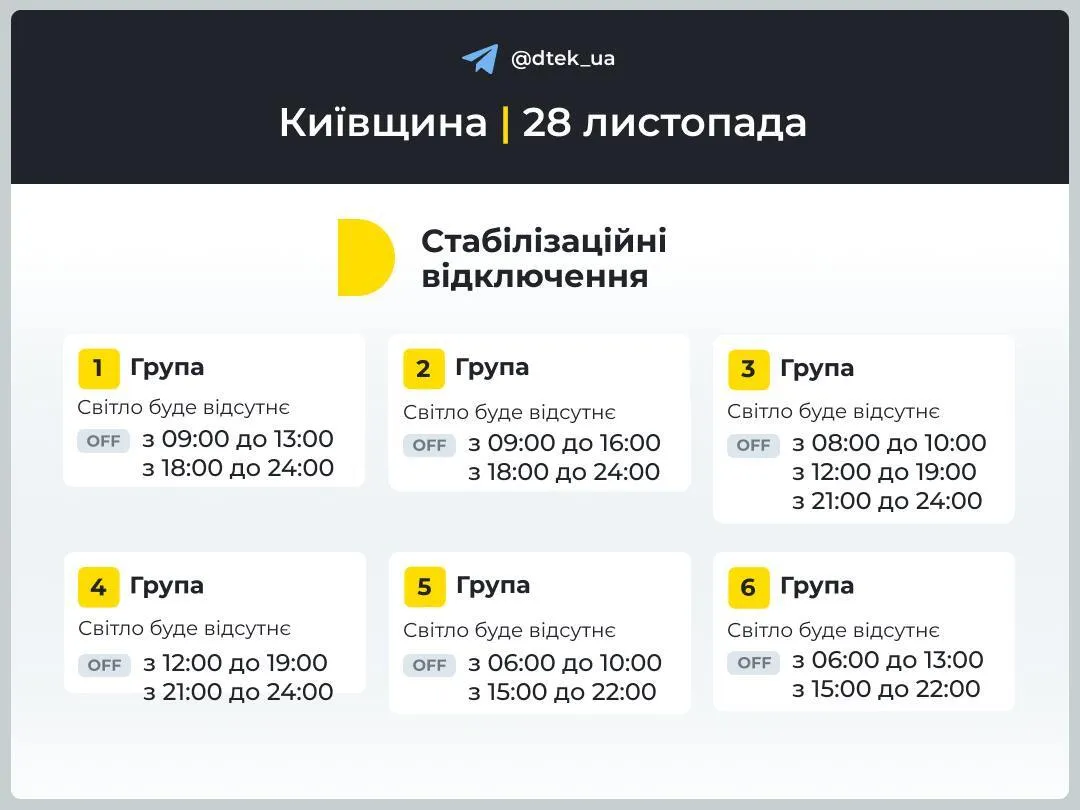

Electricity disconnection schedule for the Kyiv region.

In Odesa and the region, the maximum duration of the outage for one group will be 6 hours. In the Dnipropetrovsk region, it will be 7 hours.

Power outages in Dnipropetrovsk region
Power outages in Odesa region

In the Ternopil region, where energy facilities were severely damaged during the previous attack by the Russian Federation, scheduled power outages were also reinstated. According to the " Ternopiloblenergo ," electricity supply limits are planned during the following hours:

Currently, the schedules in Vinnytsia region can only be obtained by the subscribers via a chat-bot. The regional energy company noted that there are disruptions in the operation of the company’s official website due to high system load.

In the Volyn region, as reported by "Volynoblenergo", three-hour shutdowns are now provided for all groups. The current schedule looks like this:

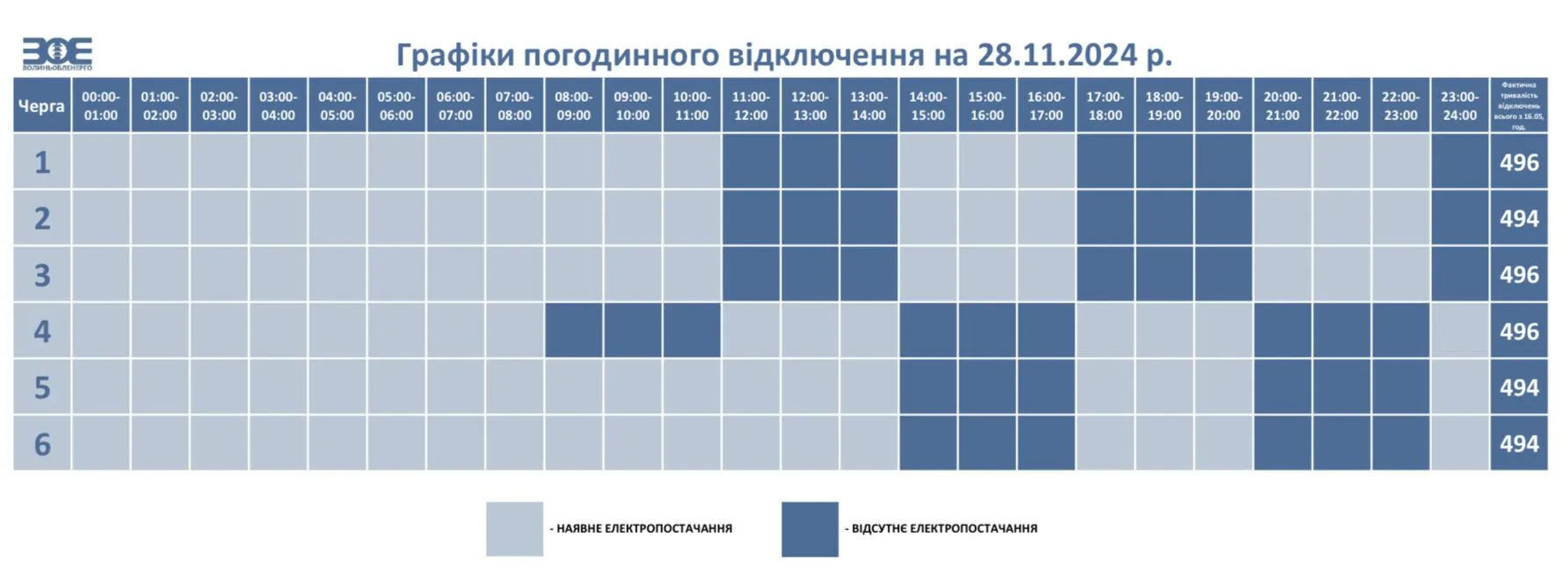

Power outage schedule in Volyn

Additionally, emergency disconnections of networks are recorded in Lutsk and Lutsk district. They are related to the application of schedules, and energy workers are engaged in repairs.

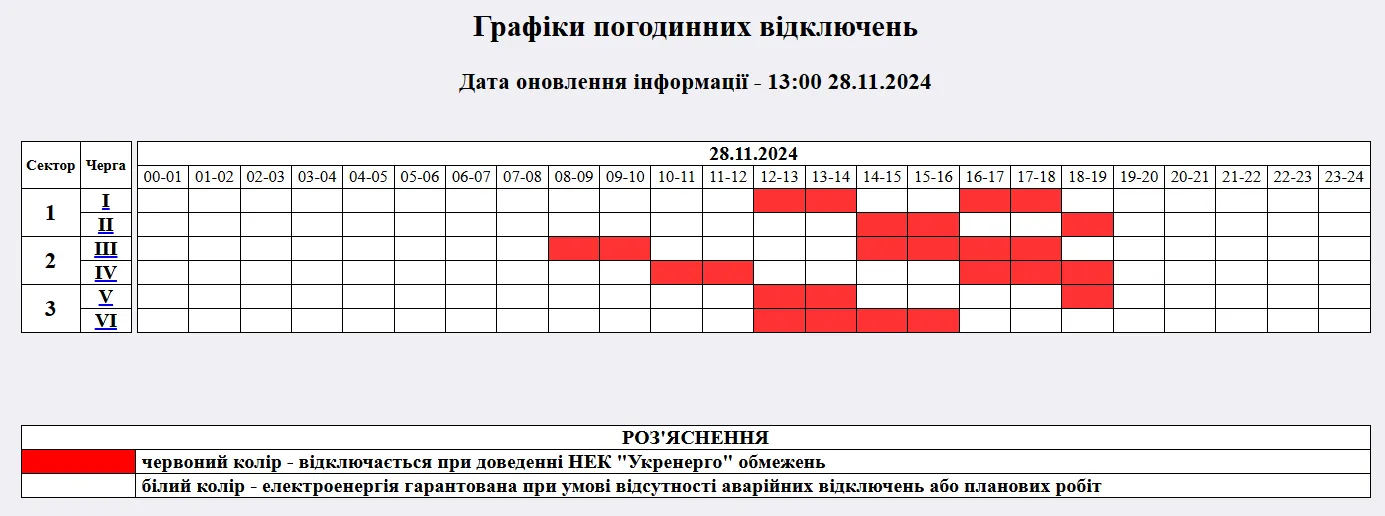

In the schedule for Zhytomyr region, after resumption, four-hour outages appeared. At the same time, there are no planned limits after 19:00 in the region:

Power outage schedule in Zhytomyr.

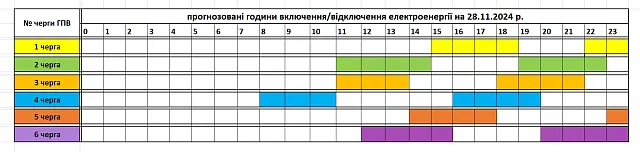

In the Transcarpathian region, after the cancellation of emergency shutdowns, the schedules also became stricter. Instead of 2-hour outages each, now there will be 4 hours without electricity in a row:

Electricity disconnection schedule for Zakarpattia

In the Zaporizhzhia region, schedules for hourly outages have also been tightened. You can find out your shift here. In the regional energy company reported that the schedule was formed as follows:

In the Kirovohrad region, new schedules have been in effect since 10 AM. The outages by shifts are distributed as follows:

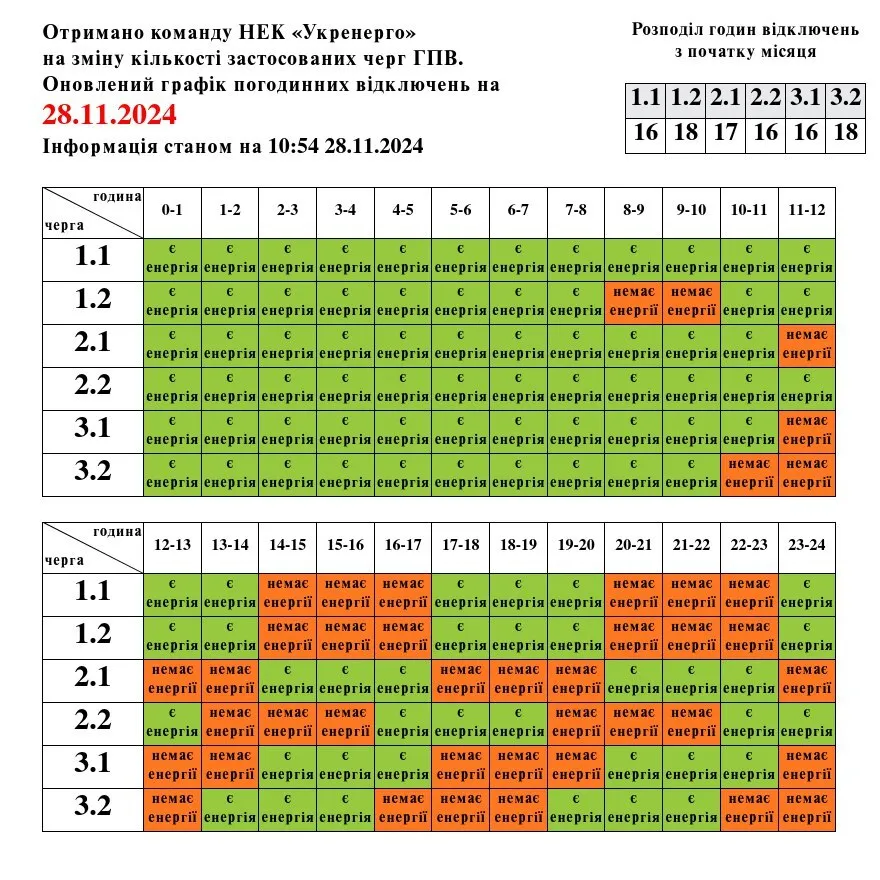

For residents of Lviv region, three-hour "blocks" of power outages have been introduced for the second half of the day.

Power outages in Lviv and region

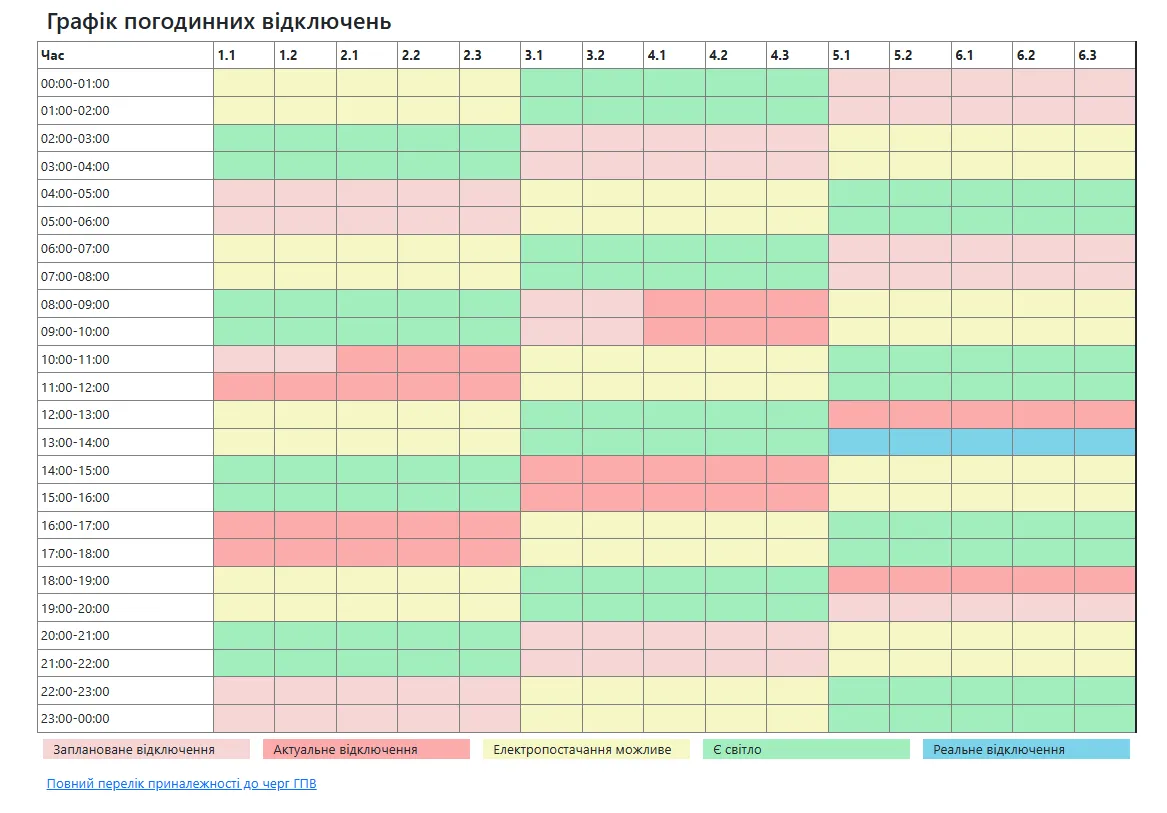

In Mykolaiv region, the schedule was adjusted, according to the regional energy company. The following outages are in place:

Power outages in Mykolaiv region

In Poltava region, outages of 2.5 hours each are planned until the evening. "Electricity shutdown occurs no earlier than the indicated start time of the shift, within 0.5 hours. Electricity connection occurs in the last 0.5 hours of the disconnected shift after the consumers of the next shift are disconnected," they explained in "Poltavaoblenergo".

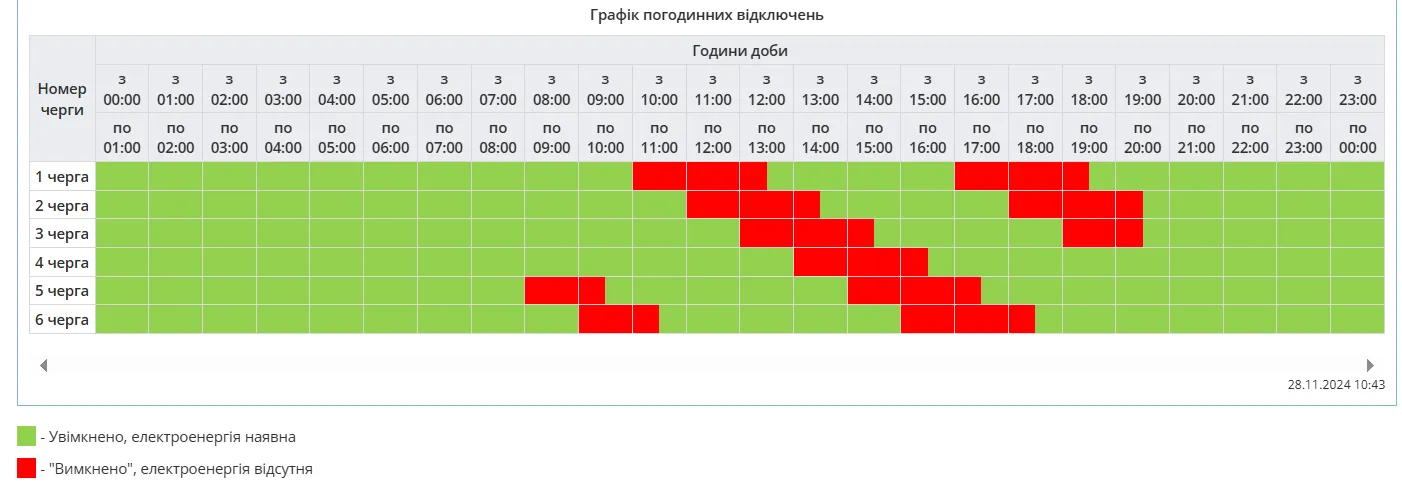

How electricity is disconnected in Poltava region

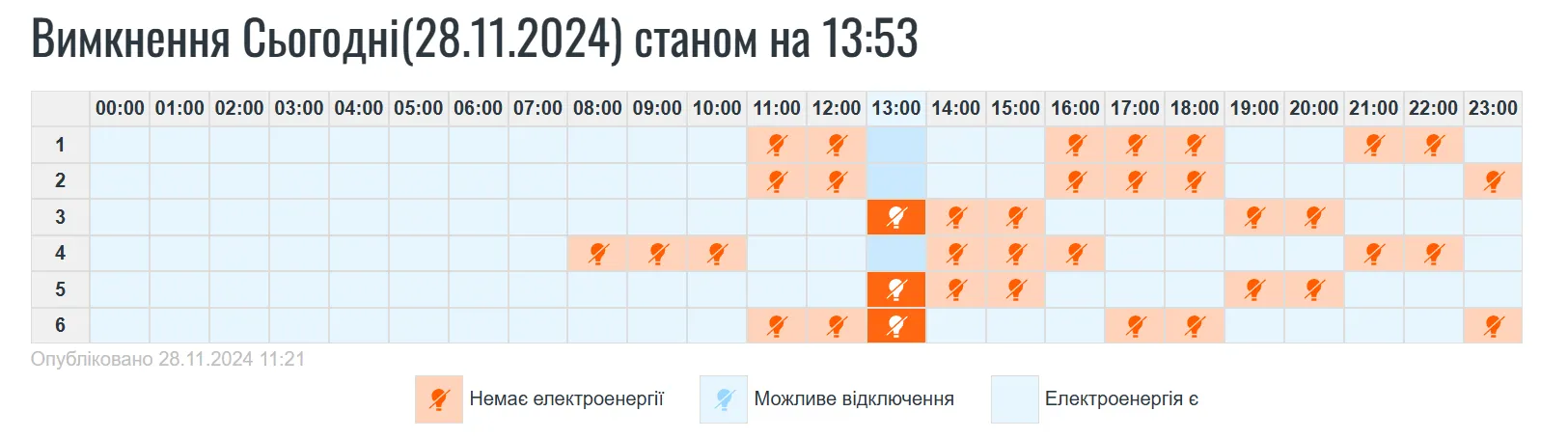

In Ivano-Frankivsk region, the longest disconnection lasts three hours. "Prykarpattiaoblenergo" published the following schedule:

Power outages in Ivano-Frankivsk

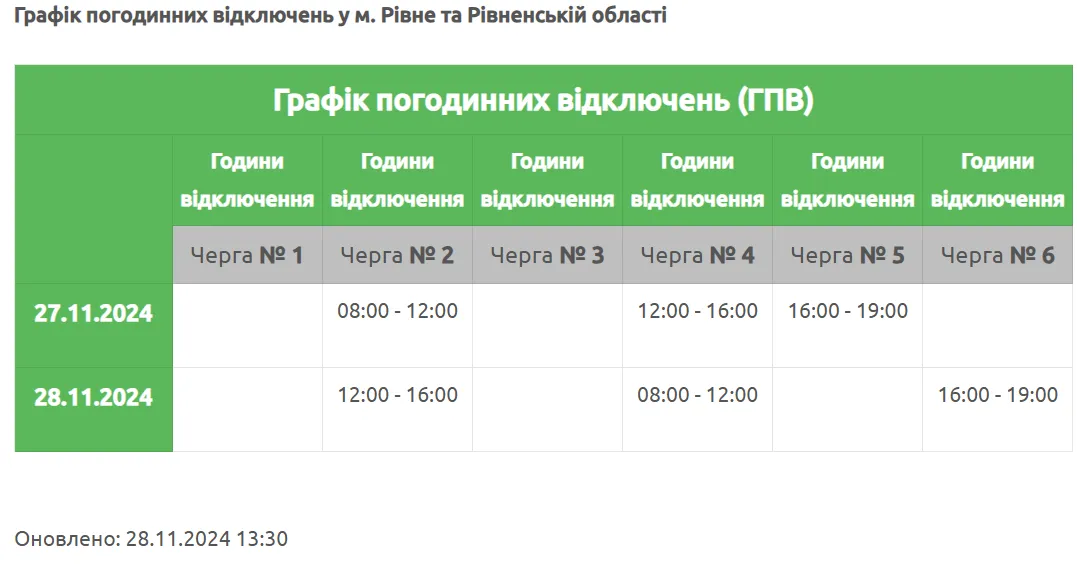

In Rivne region, each consumer is disconnected for 3 or 4 hours in a row. You can find out your shift on the website of "Rivneoblenergo". At the same time, the consequences of emergencies have been eliminated, and electricity is turned off only according to schedules.

What is the schedule of power outages in Rivne today.

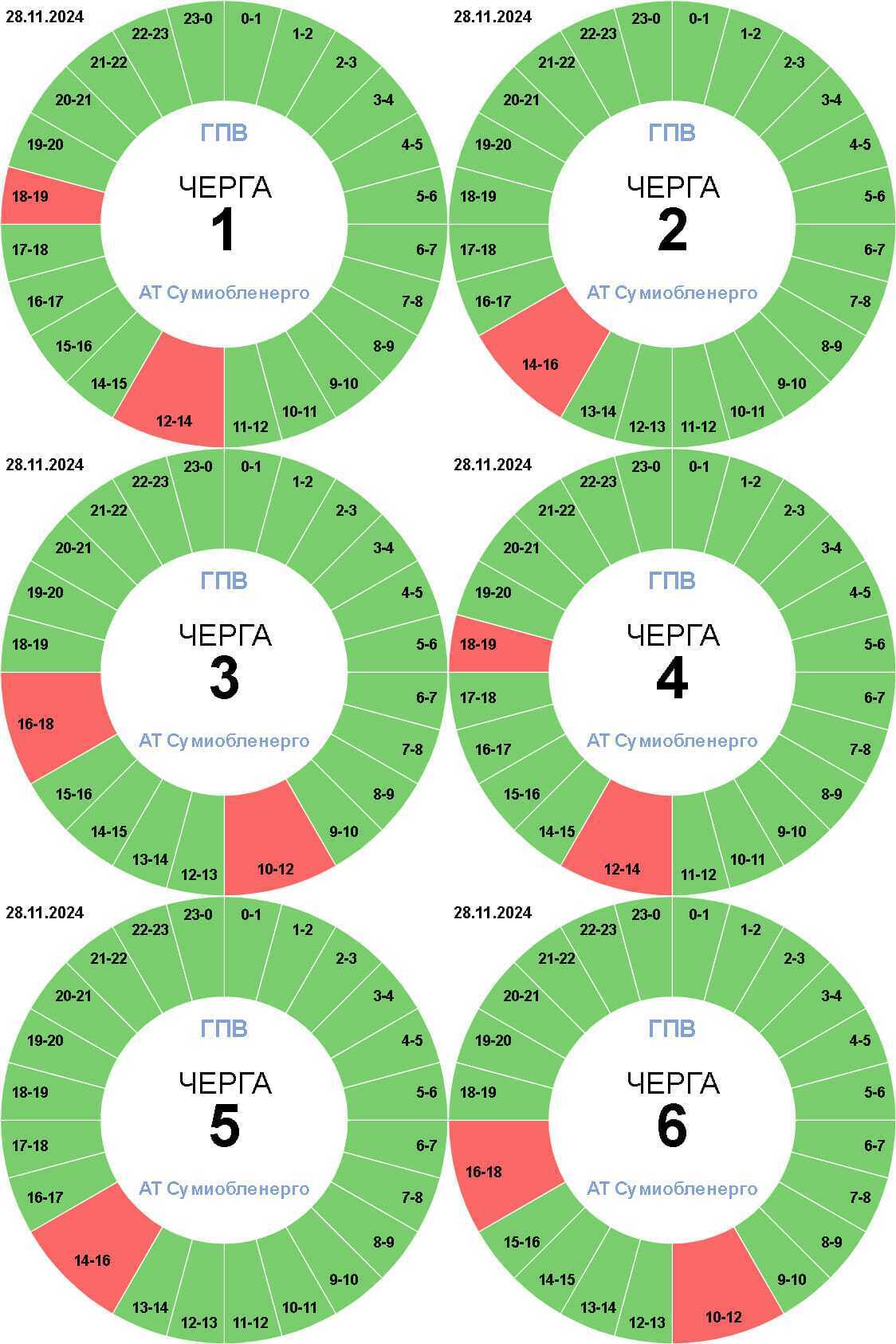

"In the Sumy region, emergency disconnection schedules have been canceled. Instead, hourly disconnection schedules are still in effect with two shifts," it was stated in "Sumyoblenergo". The current schedule looks like this:

Electricity disconnection schedule in Sumy

In Kharkiv region, according to the report from the regional energy company, all consumers returned to the hourly disconnection schedules. It has not been changed, and you can familiarize yourself with the timetable here.

The schedule in the Kherson region is published only on the website of the regional energy company. "Khersonoblenergo" warned that repair work on the lines is still ongoing. Energy workers are working in the territories of the settlements of Velyka Oleksandrivka, Bila Krynytsia, Urozhaine, Trudolyubivka, Mala Shesternya, Fedorivka, Kherson, Chornobaivka.

In Khmelnytskyi region, on November 28, a revised schedule of hourly disconnections will be in effect. "The number of shifts has been increased," they warned in the regional energy company and showed the new timetable:

Power outages in Khmelnytskyi region

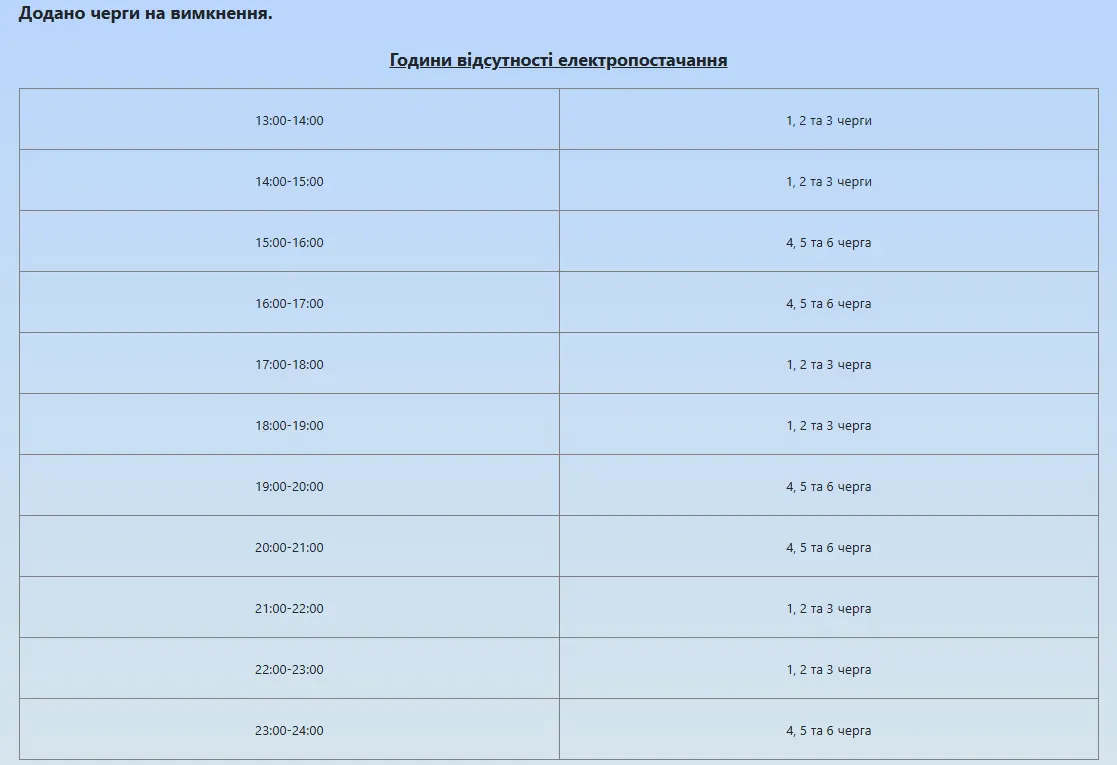

In Cherkasy region, on November 28, shifts for disconnection were also added. A list of addresses that will be disconnected by shifts can be viewed via this link.

Cherkasy region: what disconnections are in effect

In Chernivtsi region, updated schedules have also been published. "As of 13:10, the NNEK "Ukrenergo" team will apply three shifts of disconnections (9 groups simultaneously) until the end of the day," it was stated in the regional energy company.

Disconnections in Chernivtsi and region

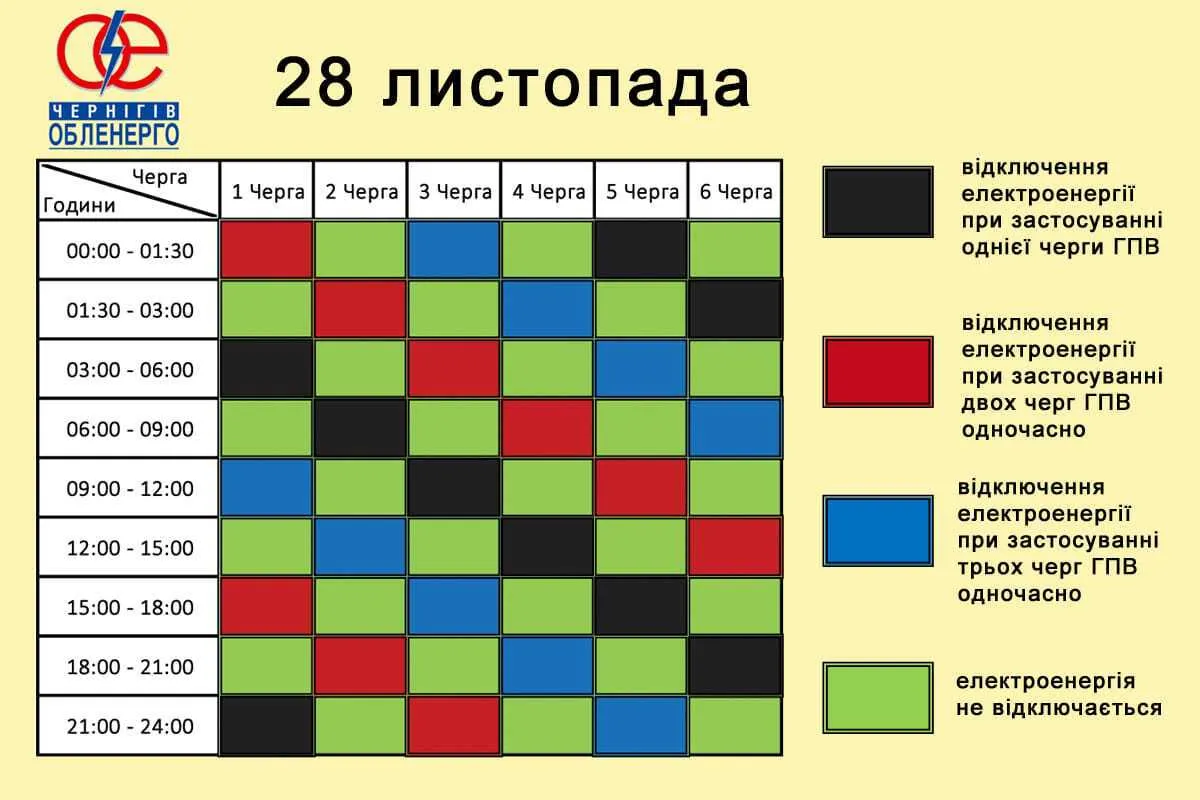

In Chernihiv region, new schedules are also in effect. "We received a command from NEK "Ukrenergo" to replace 10 shifts of the Emergency Shutdown Schedule (GAV) with two additional shifts of the Hourly Shutdown Schedule (GPV). Therefore, there are currently three GPV shifts operating in the region (black, red, and blue zones)," it was stated by "Chernihivoblenergo".

How electricity is disconnected in Chernihiv.
Date and time 28 November 2024 г., 14:52     Views Views: 3510
